Deployment schedule
- Architecture & Design: the architecture of the solutions is super simple and described in this diagram:

Even when leveraging the browser deployment, the security-first architecture is very simple:

- Installation: installation is super simple and takes less than 1 minute per user.
- Configuration : configuration of connections to the Git repository and databases is done in a few seconds.
- Migration of existing data models : the length of this step depends on the number of models and whether special adjustments are required.
- Acceptance Testing : customer may run testing at any time test against a list of specified requirements
- Knowledge Transfer : Hackolade provides online user documentation, tutorials, how-to guides, and an eLearning platform with self-paced progressive video tutorials.
- Post-Implementation Support : maintenance and support are provided for as long as the subscription is valid.

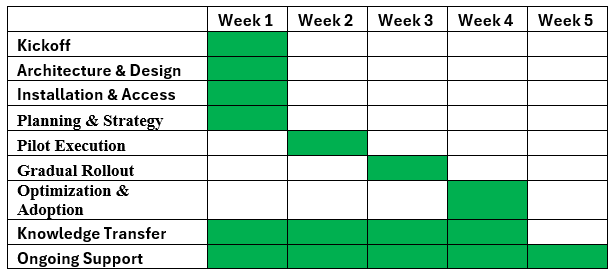

🔍 Deployment Project Plan
| Week | Activities |
|---|---|
| Week 1 | Kickoff meeting, architecture & design, tool installation, environment setup, select pilot models, document objectives. |
| Week 2 | Rebuild or import models into Hackolade Studio; validate mappings from legacy data modeling tools; resolve mismatches. |
| Week 3 | Go/No-Go for full migration |
| Week 4 | Hands-on workshop with users. Review CLI automation and Git workflows, Integrate at least one model into CI/CD pipeline. Test reverse- and forward engineering |
| Week 5 | Wrap-up: document results, team feedback, and ongoing support. |
